Production Timesheet

The time-accounted production log: a full Availability × Performance × Quality breakdown for the period, reconciled to the Augos waterfall. It's the bridge between the OEE view and the phase view.

1 · The purpose of this report

It gives managers the classic OEE decomposition they benchmark against world-class, grounded in the same loss account as everything else, and it's the standard cross-check that the Traditional and Augos bottom lines agree, which they do by construction.

2 · On the page

Top to bottom: the controls, then the period summary, then the interval log.

2.1 · Selectors

ControlWhat it does
Point selectorChoose the site or line whose OEE you want.
Date selectorSet the period the A×P×Q is calculated over.

2.2 · The A×P×Q summary

Availability, Performance and Quality, and the OEE they multiply to, shown alongside the Augos loss buckets: the planned split, unplanned stops, interruptions, the net speed and quality effects, and Net Production Time. The two bottom lines, OEE and Net Production Time, are built independently and land on the same number, which is the whole point of the page.

Reading the three factors is itself a router, a low one tells you which report to open next:

FactorReads low when…Where to go next
AvailabilityThe line stops too much.Downtime & the stoppage analyses
PerformanceIt runs below its ideal rate.Speed and interruptions
QualityToo many rejects and rework.Investigate rejects / variance
The loss-account bar: paid time split across planning efficiency, operator compliance, unplanned stops, interruptions, variance, speed loss and net production time, with a colour legend
The Augos loss buckets across paid time, ending in net production time.

2.3 · The interval table

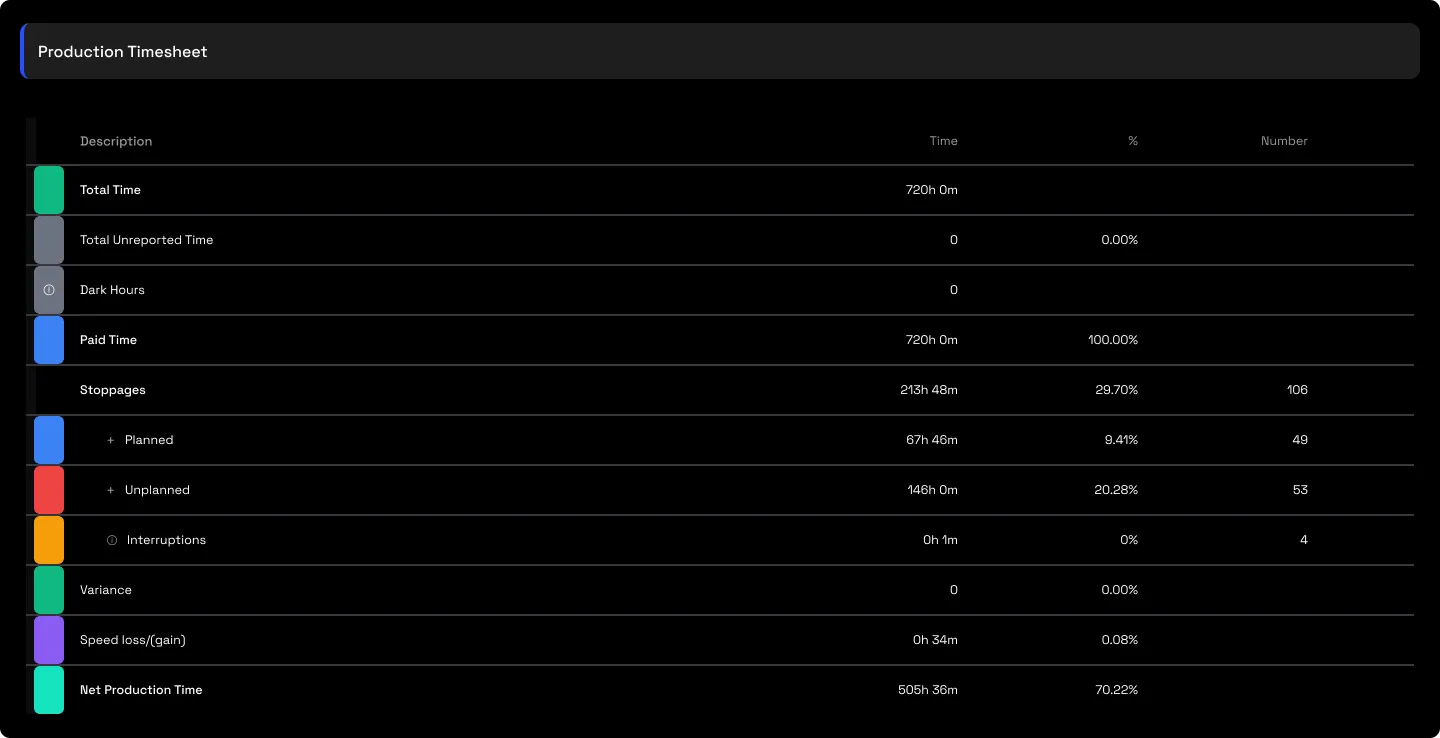

The per-interval production entries: the timesheet proper, a detailed log of what ran when.

The interval table: per-interval production entries logging description, times, counts and losses for what ran when
The interval table: the timesheet proper, a per-interval log of what ran when.

3 · Use cases

  • Find the real lever. A line can run fast and clean yet post a low OEE because it simply isn't available enough, the factors show that at a glance, so you fix uptime rather than chasing speed you already have.
  • Speak the familiar language. Give a customer "their OEE number" in the A×P×Q terms they already benchmark against, reconciled to a second, independent methodology and down to time-stamped events.

4 · Good to know

Every OEE consultant produces an A×P×Q; this one reconciles to a time waterfall and down to time-stamped events, and the two bottom lines agree to within rounding. One honest caveat: the way the planned loss is split into planning efficiency and operator discipline currently differs between this report and Performance Overview, the totals match, the internal split doesn't, so quote the Performance Overview split until that reconciliation lands.

5 · Common questions

OEE here versus Net Production Time elsewhere, which is right?

Both. They're built to agree, and they do, to within rounding. If you ever see a real gap, it's a window or mode mismatch, not two different truths.

World-class OEE is 85%, we're well below.

Read the factors. If Performance and Quality are above 90%, the whole gap is Availability: a stoppage problem with named reasons in the downtime and stoppage reports, not a "run faster" one.
